JSON Reference

A jsonantt file is a single JSON object with the following top-level keys.

Top-level fields

Field

Type

Default

Description

tasks

array

required

Ordered list of task objects.

title

string

""

Chart title. Omit to render without a title and without wasting vertical whitespace.

dateformat

string

"%Y-%m-%d"

strftime format string used to parse all dates in the file.

start

string

auto

Force the x-axis start date (overrides the earliest task date).

end

string

auto

Force the x-axis end date (overrides the latest task date).

style

object

see Style Guide

Visual style overrides. See Style Guide for all fields.

Task object

Each entry in tasks (and each entry in a task’s children array) is a task object.

Field

Type

Default

Description

name

string

required

Display label for the task.

description

string

""

Optional long description (unused in chart output, available in table columns).

id

string

Unique identifier used in not_before references.

start

string

Start date in dateformat. Required unless derived from children or not_before.

end

string

End date in dateformat. Omit when using duration.

duration

string

Duration relative to start or the end of the not_before task. Format: <N><unit>. See duration units table below.

not_before

string

id of another task. This task’s start is automatically set to that task’s effective end date. Must be paired with duration.

color

string

palette

Hex color for this task’s bar or milestone marker. Children without an explicit color inherit this value (and can be auto-lightened via subtask_lightening_pct).

milestone

boolean

false

When true the task is rendered as a diamond marker, not a bar.

date

string

The milestone date. Used only when milestone: true.

Milestone field summary

Field

Type

Default

Description

milestone

boolean

false

Render as a marker instead of a bar

date

string

Point-in-time date for the milestone

color

string

style default

Marker fill color (e.g. "#FFD700")

marker

string

"D"

Matplotlib marker: "D" diamond, "*" star, "^" triangle

marker_size

number

14.0

Override marker size in points

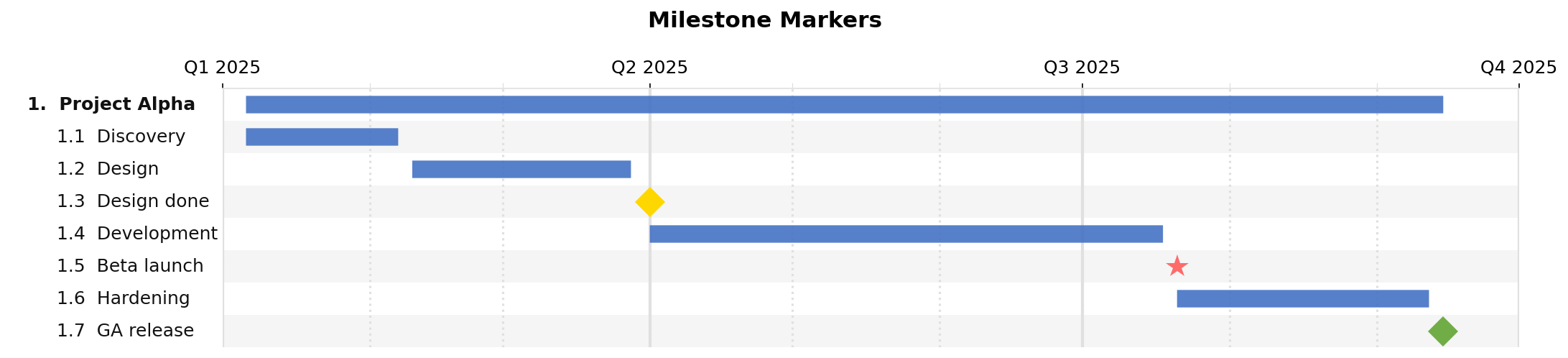

Example: milestones with different markers

{
  "title": "Milestone Markers",
  "dateformat": "%Y-%m-%d",
  "style": { "major_tick": "quarter", "minor_tick": "month" },
  "tasks": [{
    "name": "Project Alpha",
    "children": [
      { "name": "Discovery",   "start": "2025-01-06", "end": "2025-02-07" },
      { "name": "Design done", "milestone": true, "date": "2025-04-01",
        "color": "#FFD700" },
      { "name": "Development", "start": "2025-04-01", "end": "2025-07-18" },
      { "name": "Beta launch", "milestone": true, "date": "2025-07-21",
        "color": "#FF6B6B", "marker": "*", "marker_size": 16 },
      { "name": "GA release",  "milestone": true, "date": "2025-09-15",
        "color": "#70AD47" }
    ]
  }]
}
Milestone markers example

Other task fields

Field

Type

Default

Description

bold

boolean

false

Force bold label text on this task (independent of bold_tasks).

marker

string

"D"

Matplotlib marker symbol for milestones. "D" = diamond, "*" = star, "^" = triangle, etc.

marker_size

number

style default

Override the milestone marker size in points for this task only.

children

array

[]

Nested sub-tasks. A task with children derives its start/end from the earliest/latest child dates. The bar is rendered as a summary bar (thinner, with a different appearance).

(any)

any

Any additional field is stored on the task and is accessible as a table column via style.table_columns. Example: "cost": 50000, "owner": "Alice".

Duration units

Suffix

Unit

Behaviour

d

Days

Exact calendar days. "14d" = 14 days.

w

Weeks

7 calendar days each. "2w" = 14 days.

m

Months

Calendar months. "3m" from Jan 6 ends Apr 6.

y

Years

Calendar years. "1y" from Jan 1 2024 ends Jan 1 2025.

Examples: "90d", "3m", "2w", "1y", "18m".

Duration and chaining example

{
  "title": "Duration & not_before Scheduling",
  "dateformat": "%Y-%m-%d",
  "tasks": [
    { "id": "design",   "name": "Design",
      "start": "2025-01-06", "duration": "2m", "color": "#4472C4" },
    { "id": "backend",  "name": "Backend",
      "not_before": "design", "duration": "3m", "color": "#70AD47" },
    { "id": "frontend", "name": "Frontend",
      "not_before": "design", "duration": "2m", "color": "#ED7D31" },
    { "id": "qa",       "name": "QA & Testing",
      "not_before": "backend", "duration": "6w", "color": "#FF5757" }
  ]
}
Duration and not_before chaining

Date resolution order

jsonantt resolves each task’s start and end using the first applicable rule:

  1. Explicit start + end — used as-is.

  2. Duration start + durationend is computed.

  3. Chain not_before + durationstart is set to the effective end of the referenced task; end is then computed.

  4. Parent — a task with no dates and no not_before/duration derives its range from its children.

Minimal example

{
  "dateformat": "%Y-%m-%d",
  "tasks": [
    {
      "name": "Project",
      "children": [
        { "name": "Kick-off",  "start": "2025-01-06", "end": "2025-01-17" },
        { "name": "Delivery",  "milestone": true, "date": "2025-06-30", "color": "#FFD700" }
      ]
    }
  ]
}

Full skeleton

{
  "title": "My Project",
  "dateformat": "%Y-%m-%d",
  "start": "2025-01-01",
  "end":   "2025-12-31",
  "style": {
    "major_tick": "year",
    "minor_tick": "quarter"
  },
  "tasks": [
    {
      "id": "phase1",
      "name": "Phase 1",
      "color": "#4472C4",
      "children": [
        {
          "id": "task-a",
          "name": "Task A",
          "start": "2025-01-06",
          "duration": "6w"
        },
        {
          "id": "task-b",
          "name": "Task B",
          "not_before": "task-a",
          "duration": "2m"
        },
        {
          "name": "Phase 1 done",
          "milestone": true,
          "date": "2025-04-01",
          "color": "#FFD700"
        }
      ]
    }

  ]
}
